Sample File & Results (Projects)

This page covers how to fill out your project import file and what your projects look like once they're in Mosaic. For the steps to upload and run the import, see the import walkthrough.

Throughout this page we use one example file with five projects — three fee-based and two hours-based — to show how everything fits together, including how both budget styles can live in the same file.

📘

Download the template

Start from the sample file, then replace the example rows with your own data.

What one import can create

A single file can build a full project hierarchy:

  • Projects — name, client, description, budget/fee, cost, currency, and rate settings
  • Phases and subphases — up to 10 nested levels, with start/end dates, budgets, contract type, and milestones
  • Work categories — the activity breakdown within each phase, with their own dates and budgets

Portfolios and rate groups are referenced, not created — they must already exist in Mosaic before you import.

How the file is structured

RequirementValue
File types.csv, .xlsx, or .tsv
Max file size20 MB
First rowColumn headers
Each rowOne line item of your project structure

Each row is one line of the structure, and you repeat the project across its rows. A project with three phases uses three rows that repeat the Project name and vary the phase columns. Mosaic groups rows into the same project when the Project (and Project Ref#, if used) match.

How the example file is laid out

The example file has 16 rows that build 5 projects. The first three track budgets in fees/dollars; the last two track in hours:

RowsProjectBudget styleWhat the rows describe
1–3125 Bluestone Way (Residential Projects)FeePhase "Preliminary Design" (subphases + a "Planning" work category), plus a "Permit Approval" milestone
4–5Oakridge Office Fit-Out (Commercial Projects)FeeTwo phases, each with one work category
6–9Lakeside Retail Center (Commercial Projects)FeeFour phases, including a "Permitting" milestone
10–12Riverside Community Center (Public Works)HoursThree phases (subphases + work categories) and a "Design Approval" milestone
13–16Harbor Point Renovation (Commercial Projects)HoursThree phases, including "Construction Documents" with two work categories and a "Final Handover" milestone

Notice how the Portfolio, Project, Ref#, Client, and Description columns repeat identically on every row of the same project — that's how Mosaic keeps them together. The phase and work-category columns are what change row to row.

Here's a trimmed slice of the file — the three 125 Bluestone Way rows, plus the first row of the next project:

ProjectRef#PhaseSubphase 1Start DateEnd DatePhase FeeMilestoneWork Category
125 Bluestone Way210050Preliminary DesignConcept Development2026-03-012026-03-201000FALSE
125 Bluestone Way210050Preliminary DesignConcept Development2026-03-012026-03-201000FALSEPlanning
125 Bluestone Way210050Permit Approval2026-05-152026-05-15TRUE
Oakridge Office Fit-Out210075Design DevelopmentSpace Planning2026-01-102026-04-3060000FALSEInterior Layout

What to notice:

  • Rows 1–3 repeat 125 Bluestone Way and 210050 — every row of the same project repeats its Project and Ref#, which is how Mosaic groups them into one project. Row 4's Project changes, starting a new one.
  • Dates use YYYY-MM-DD (e.g. 2026-03-01) — any other format is rejected.
  • Row 3 is a milestone (Phase Is Milestone = TRUE) — a single date (start = end) and no fee or budget.
  • Project is the only always-required column — the dashes mark cells you can safely leave blank.
📘

One header, blanks where a column doesn't apply

Every project uses the same set of columns. Fee-based projects fill in Project Fee / Budget and leave Project Budget Hours blank; hours-based projects do the opposite. You don't need a value in every column — just fill what applies to each project.

The hours-based projects (rows 10–16)

The last two projects — Riverside Community Center (1200 hrs) and Harbor Point Renovation (2400 hrs) — track budgets in hours using the Project Budget Hours column instead of the fee/budget columns. A few things they show:

  • Hours-based projects leave the fee/dollar columns blank (Project Fee, Project Budget, phase budgets). Their contract types are Hourly and the "Budget With" values are time-based (Total Member Time Budget, Total Spent + Planned Time).
  • A phase with more than one work category repeats the phase across rows — Harbor Point's "Construction Documents" appears on two rows so it can carry both "Drafting" and "Specifications."
  • Milestones ("Design Approval", "Final Handover") use the same start and end date and leave budget/contract/work-category cells blank.
📘

Note

The Project Budget Hours column only maps when the target workspace is in hours-only mode. In a fee-based workspace it won't appear — use Project Fee / Budget instead.

Column reference

Only Project is always required. Include just the columns that apply to your data — leave the rest out. These are the columns used in the example file.

📘

Note

Some columns (cost budget, budget hours, priority, region, currency, etc.) only appear if the matching feature is turned on in your workspace. If a column you expect is missing, that feature may be off.

Project columns

ColumnRequired?Format / accepted valuesExample
Portfolio NameRequired only if importing into portfoliosMust match an existing portfolioCommercial Projects
Project✅ AlwaysText — the project nameOakridge Office Fit-Out
Project Ref#ConditionalRequired when two projects share the same name210075

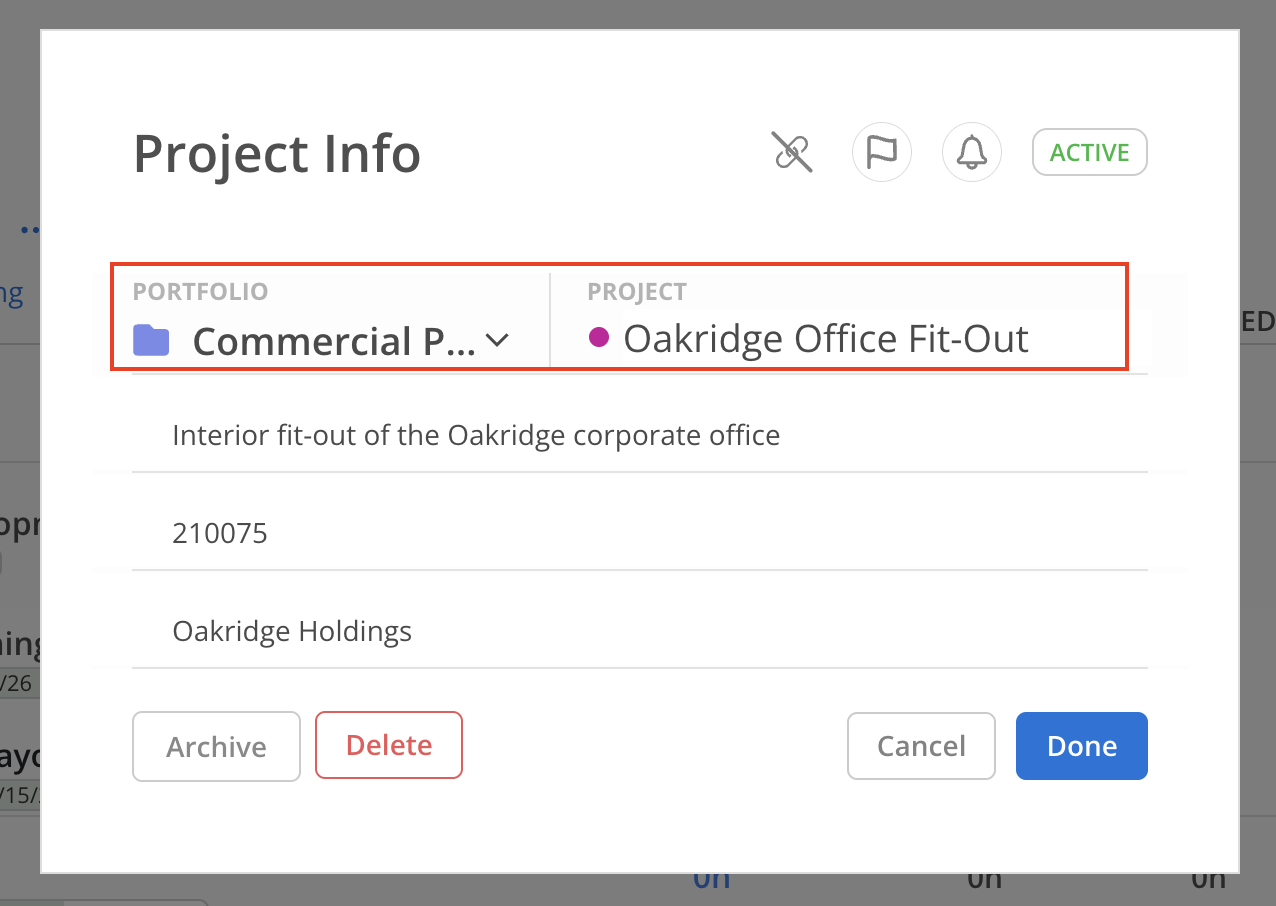

Project ClientOptionalText — existing clients are suggestedOakridge Holdings
Project DescriptionOptionalTextInterior fit-out of the Oakridge corporate office
Project FeeOptionalZero or a positive number120000
Project BudgetOptionalZero or a positive number90000
Project Budget CostOptionalZero or a positive number (cost-rates feature)85000
Project Budget HoursOptionalZero or a positive number (hours-only workspaces)(blank)

Phase columns

ColumnRequired?Format / accepted valuesExample
PhaseOptionalThe phase name (or "Main Project Phase")Design Development
Phase Ref#OptionalAn identifier for the phase100
Subphase 1 … Subphase 9OptionalNames for nested levels (10 deep total)Space Planning
Subphase Ref# 1 … 9OptionalIdentifiers for each subphase110
Phase Start DateOptionalYYYY-MM-DD2026-01-10
Phase End DateOptionalYYYY-MM-DD — on or after the start date2026-04-30
Phase OrderOptionalA whole number greater than 0, unique within its parent1
Phase Budget StatusOptionalMust match a budget status in your workspaceActive, Not Started
Phase Fee / Phase BudgetOptionalZero or a positive number60000

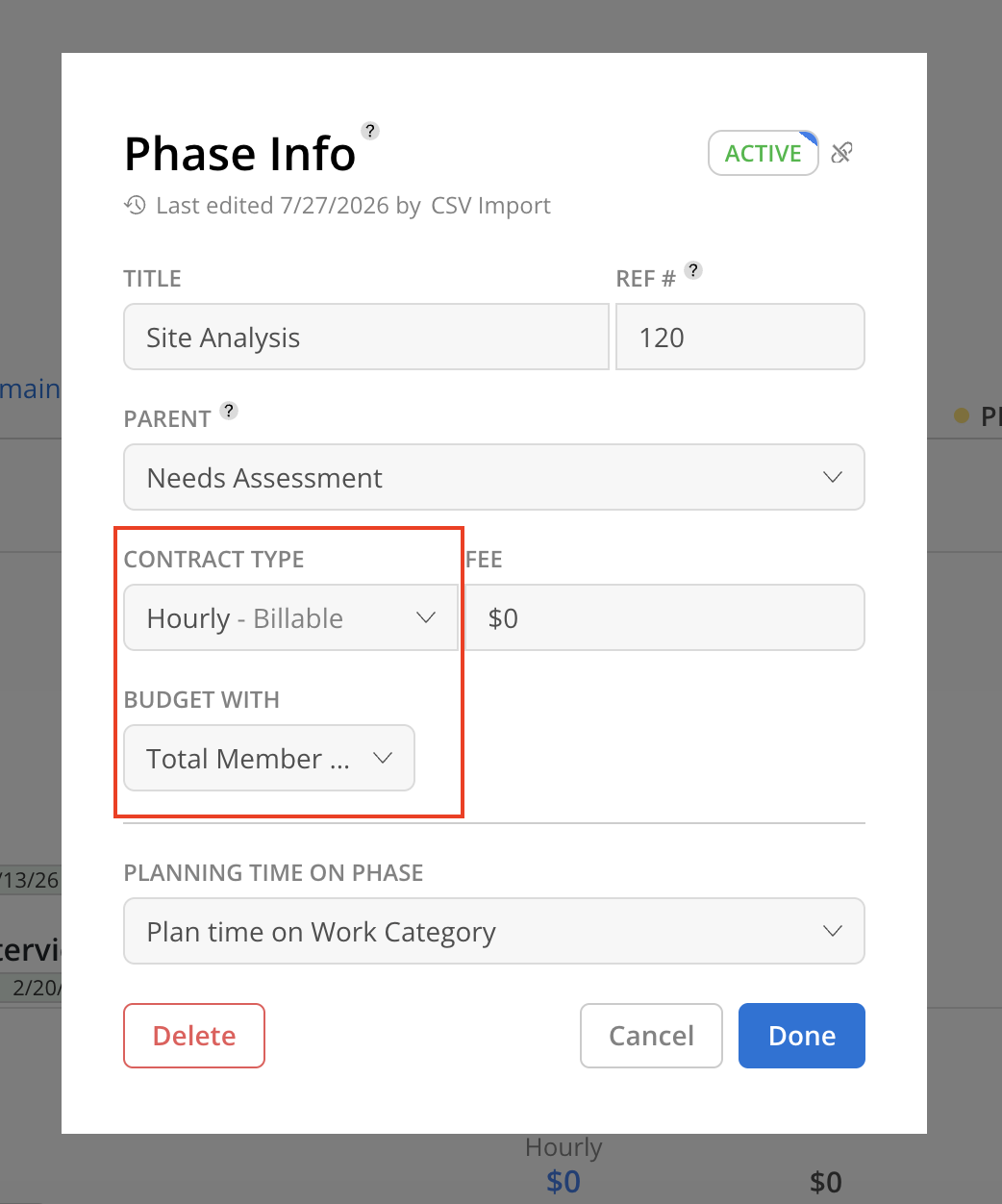

Phase Contract TypeOptionalFixed Fee or HourlyHourly
Phase Is MilestoneOptionaltrue / false — milestones cannot carry a budget, fee, or contract typefalse
Phase Budget WithOptionalSee accepted values belowUse Entered Budget

Accepted "Phase Budget With" values: Use Entered Budget · Total Spent + Planned Time · Total Member Time Budget · Subphases + Work Categories Budgets

Work-category columns

ColumnRequired?Format / accepted valuesExample
Work CategoryOptionalThe activity nameInterior Layout
Work Category Ref#OptionalAn identifierC10
Work Category Start / End DateOptionalYYYY-MM-DD2026-01-15
Work Category Fee / BudgetOptionalZero or a positive number20000
Work Category Contract TypeOptionalFixed Fee or HourlyHourly
Work Category Budget WithOptionalSee accepted values belowTotal Spent + Planned Time

Accepted "Work Category Budget With" values: Use Entered Budget · Total Spent + Planned Time · Total Member Time Budget · Use % of Phase Budget

Rules that keep your file valid

Getting these right up front prevents almost every import error:

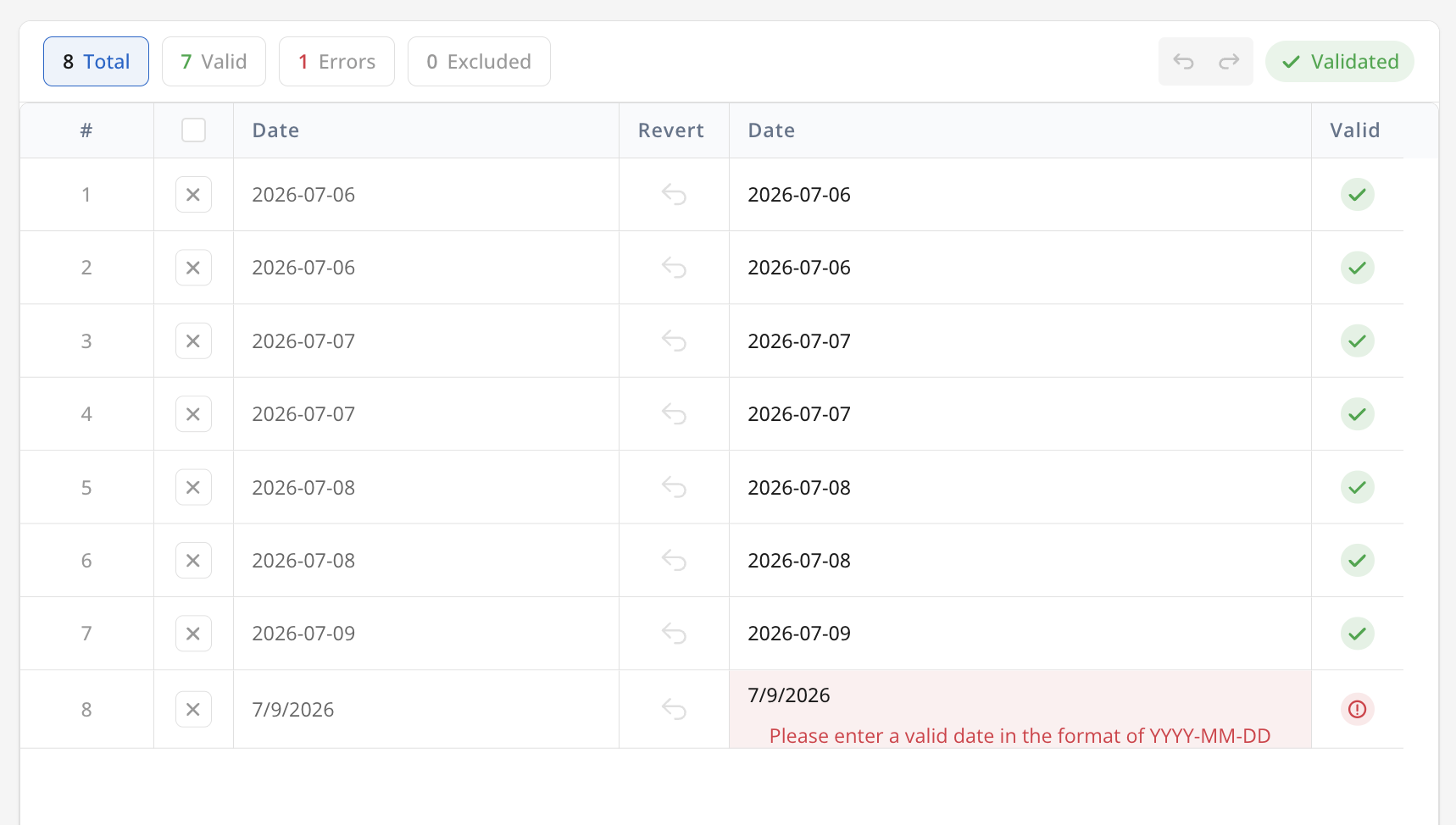

  • Dates must be YYYY-MM-DD (e.g. 2026-03-15). Any other format is rejected.
  • End dates must fall on or after the matching start date. (A milestone uses the same date for start and end — see "Permit Approval," 2026-05-15 to 2026-05-15.)
  • Repeat project values consistently. The Portfolio, Client, Description, Fee, and Budget must be the same on every row of a given project — mismatches are flagged.
  • Milestones (Phase Is Milestone = true) can't carry a budget, fee, contract type, budget status, or work categories — leave those cells blank, as the example does.
  • Don't set both a fixed budget and a "budget as % of fee" for the same item.
  • Duplicate project names need a unique Project Ref# to tell them apart.
  • "Budget With" and "Contract Type" must be spelled exactly as listed above.

What your import looks like in Mosaic

The clearest place to see an imported project is its Budget. Open the project and click Budget — the budget modal lays out everything the file created in one table, mirroring your rows almost one-for-one. Here's where each column lands:

  • The phase hierarchy becomes the rows of the budget table — phases, their subphases nested beneath, and work categories under those.

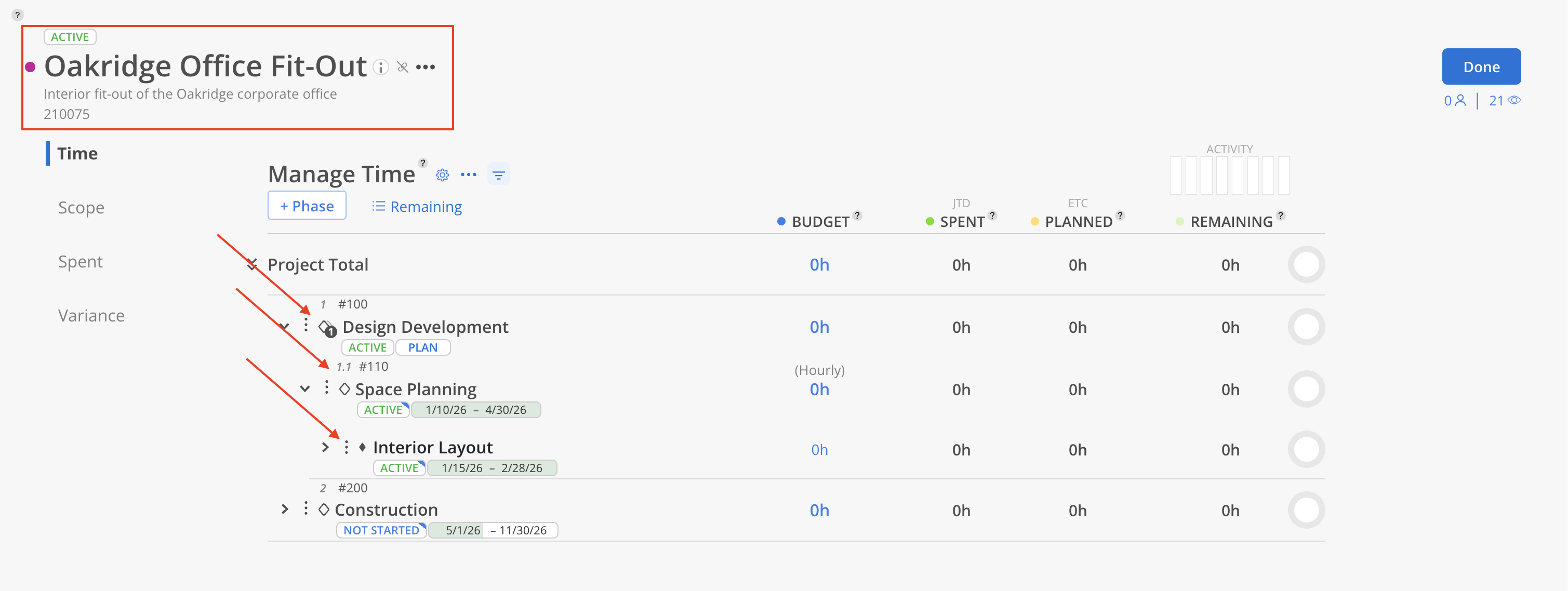

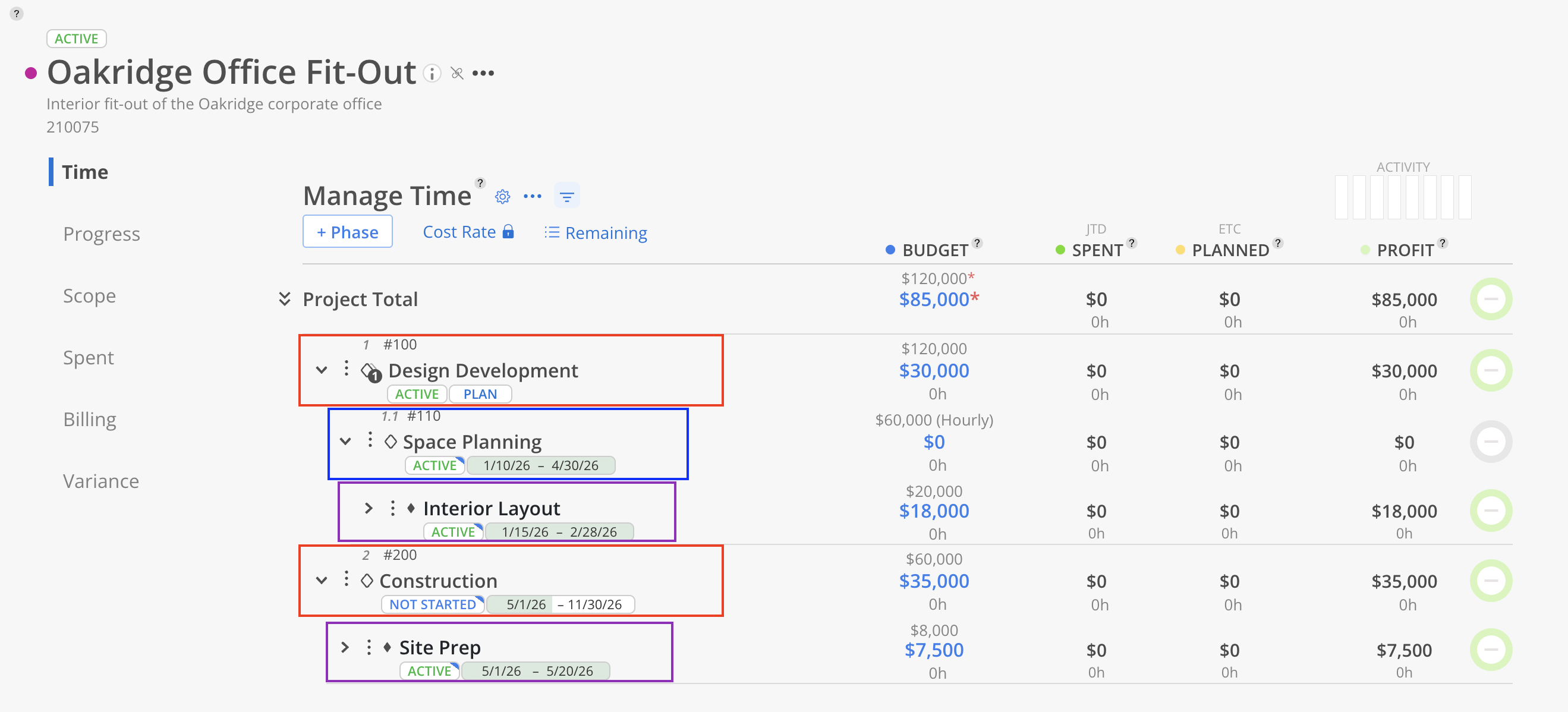

    For example, Oakridge Office Fit-Out nests Design Development → Space Planning → Interior Layout (phase → subphase → work category) and Construction → Site Prep (a work category straight under the phase)

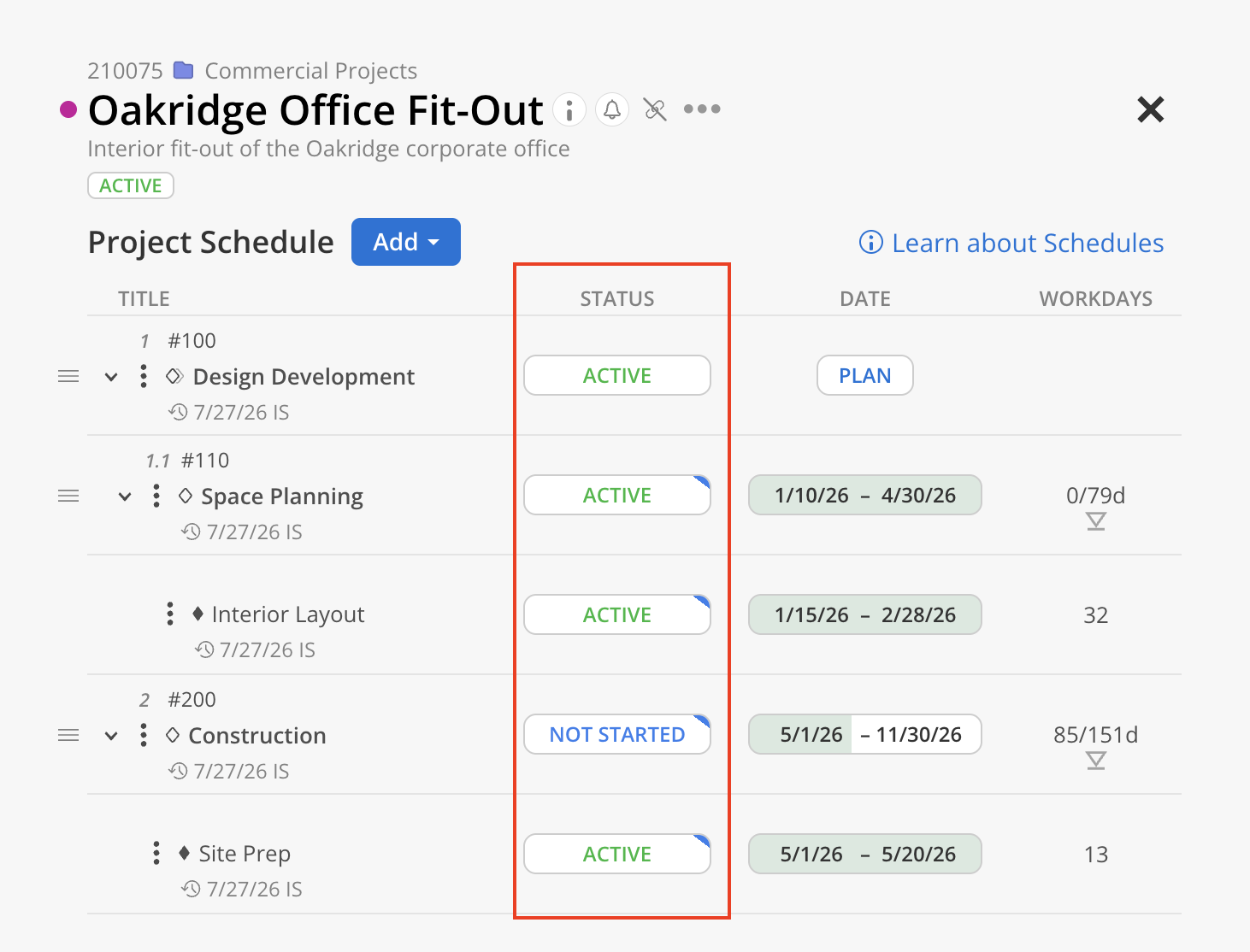

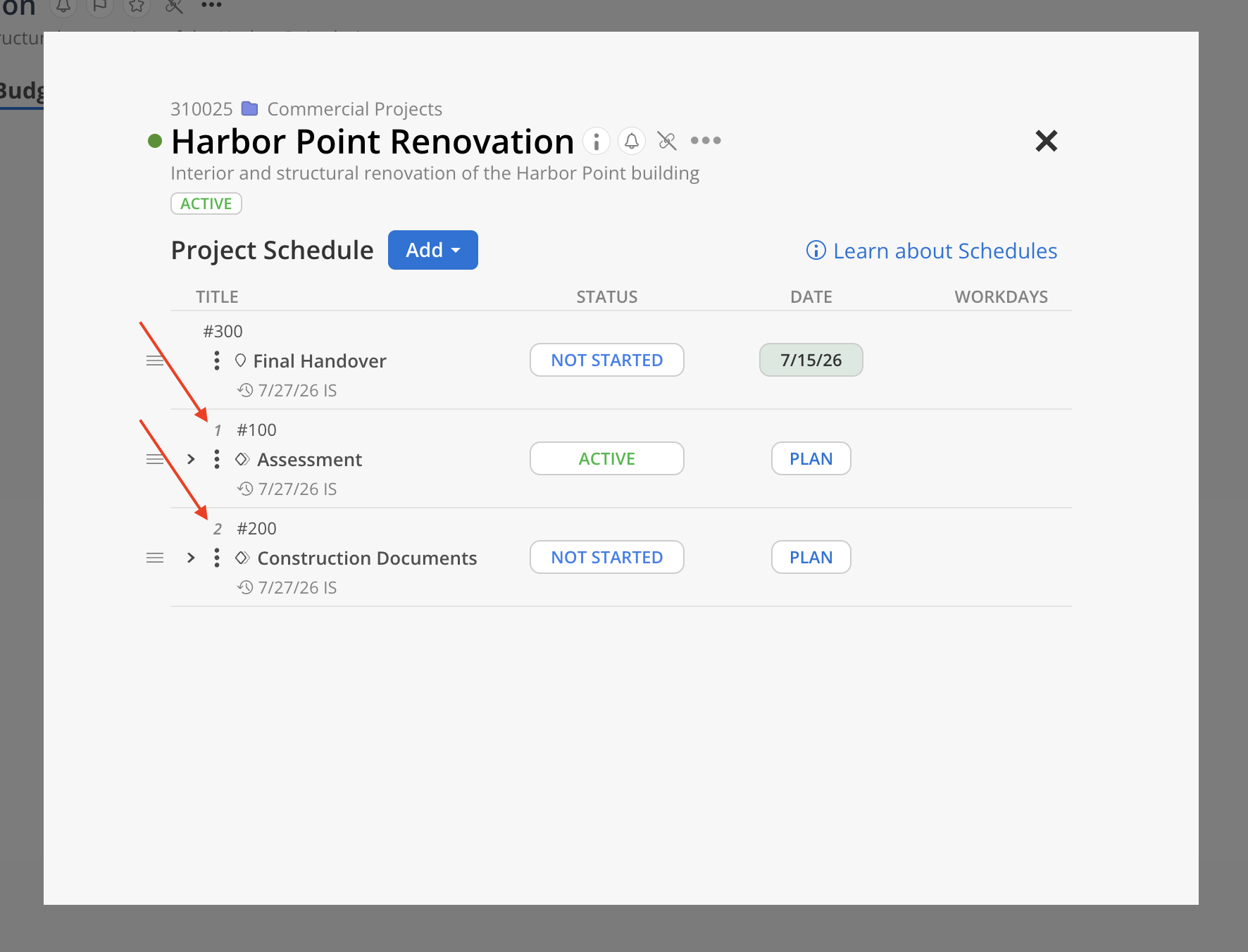

  • Phase Order controls the sequence phases and subphases appear in — you'll see it reflected in both the Project Schedule modal and the Budget table. Milestones are the exception: the Phase Order value isn't applied to them.

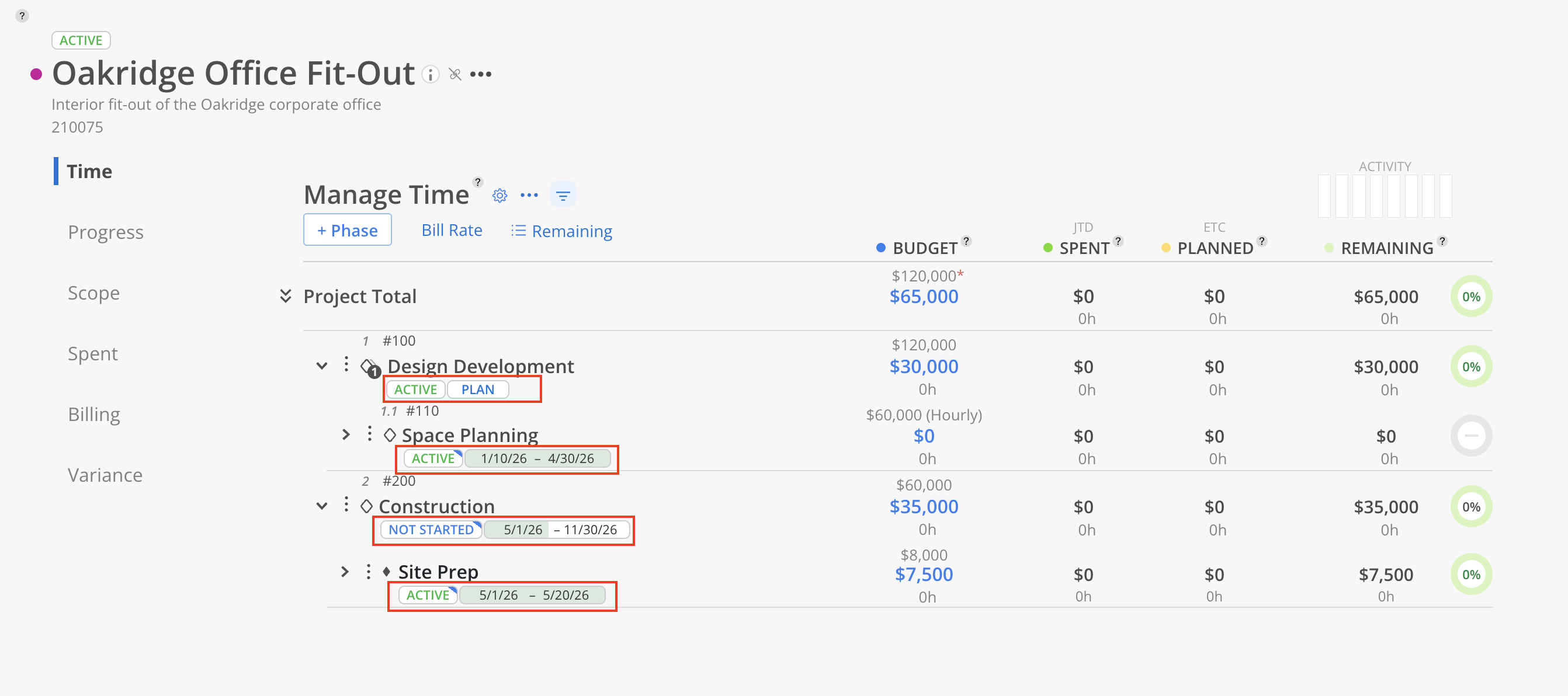

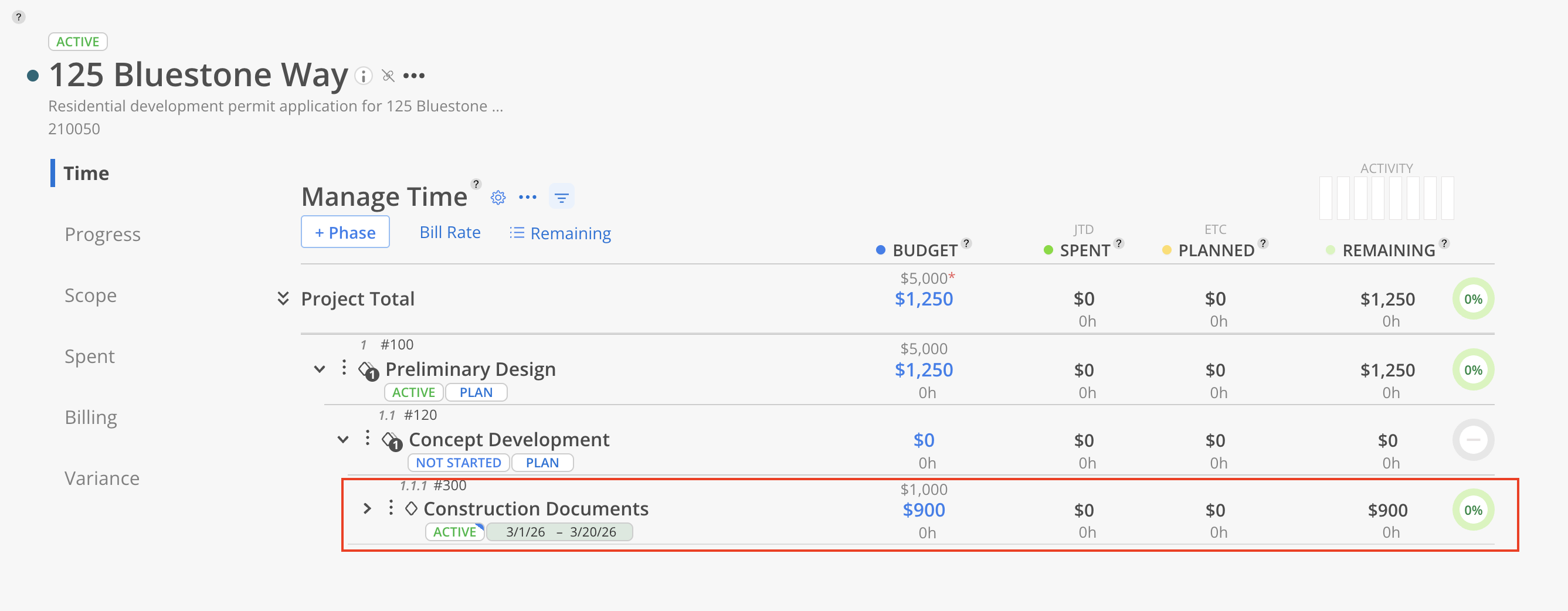

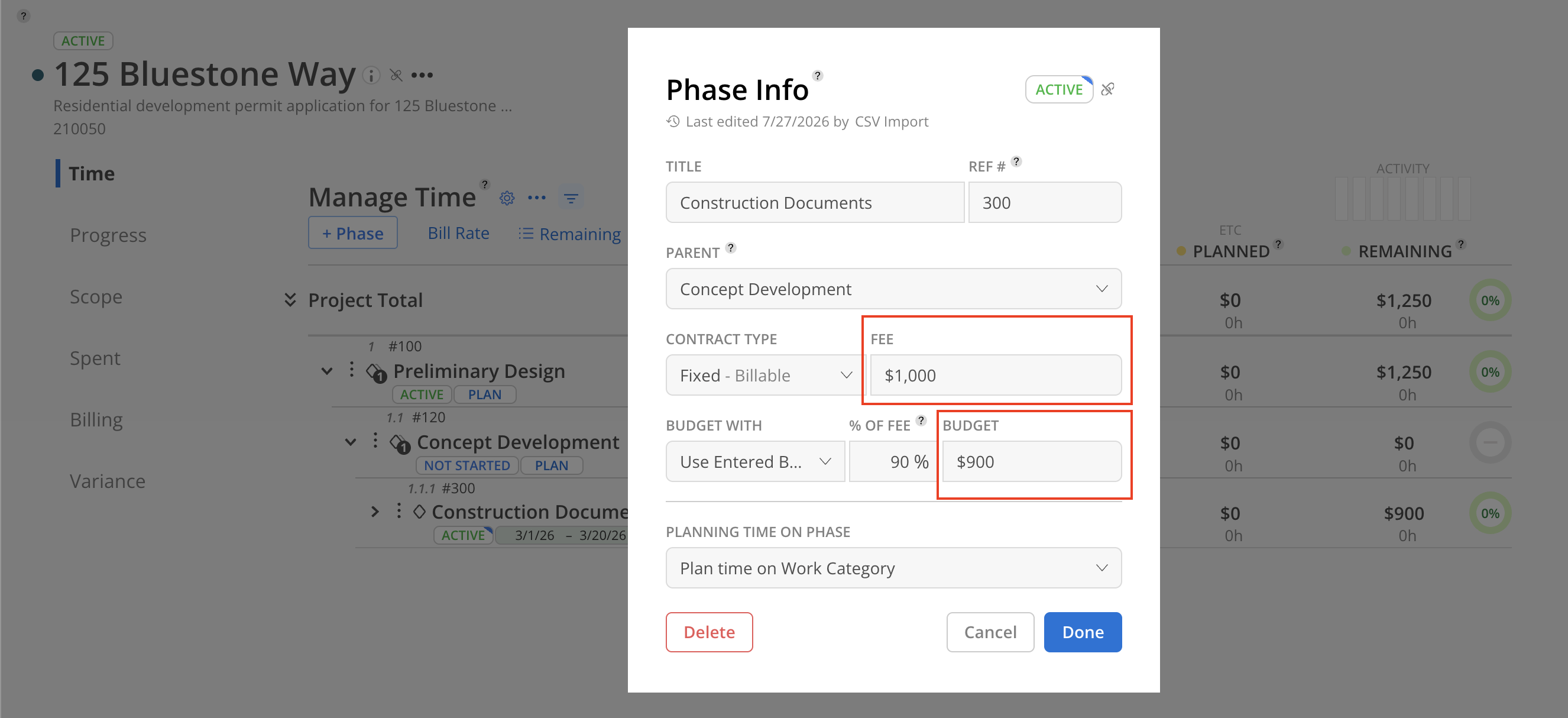

  • Fee and Budget columns carry your Phase Fee / Phase Budget and Work Category Fee / Budget straight into the table. For example, 125 Bluestone Way's Construction Documents shows a 900 budget in the table, and opening its Phase Info reveals the imported 1,000 fee and 900 budget. The project-level Fee, Budget, and Budget Cost roll up as the project total at the top.

  • Contract Type shows each phase and work category as Fixed Fee or Hourly. Click the budget cell of a Phase on the Budget Table to see the field.

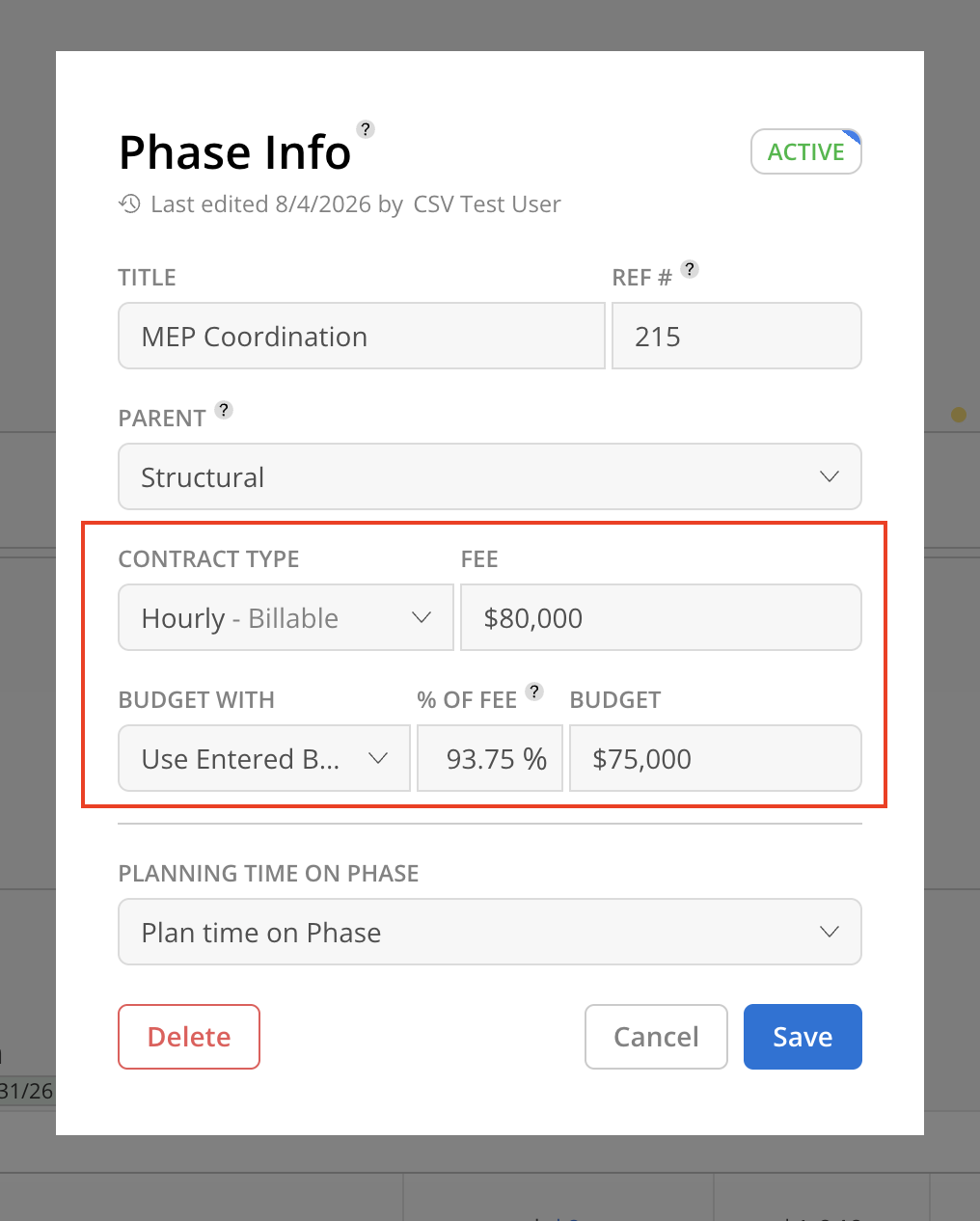

  • Budget With sets how each row is budgeted — Use Entered Budget, Total Member Time Budget, Total Spent + Planned Time, or Use % of Phase Budget. Click the budget cell of a Phase on the Budget Table to see the field.

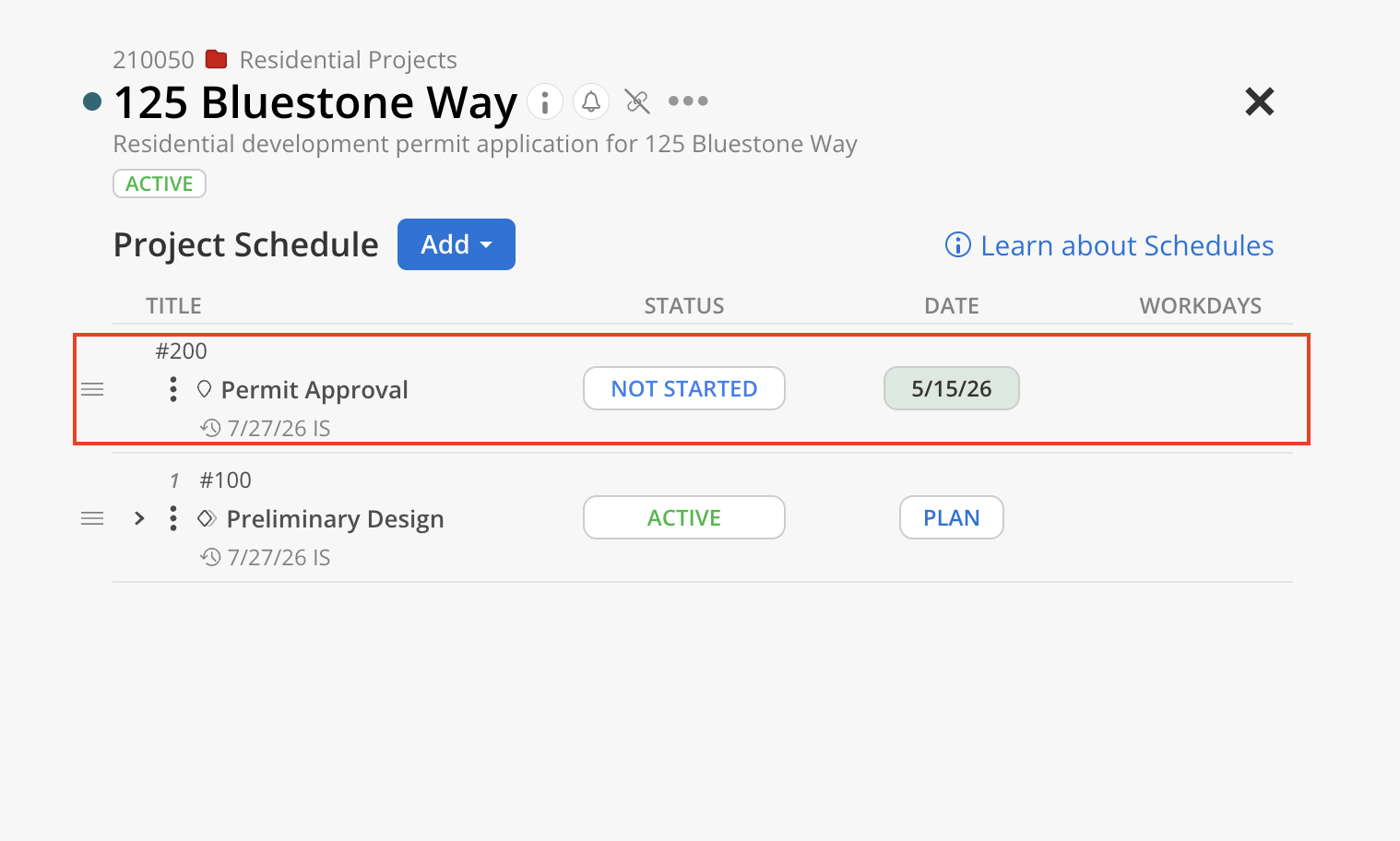

  • Phase Is Milestone = true appears as a milestone marker on a single date — e.g. Bluestone's Permit Approval and Lakeside's Permitting.

  • Phase Budget Status shows each phase's status. For example Oakridge's Design Development is Active and Construction is Not Started. You set it per phase from your workspace's configured statuses; it's required on non-milestone phases and left blank on milestones.

  • Start / End Dates populate the date fields for each phase and work category, which also drive the bars on the Project Planner / Timeline.

The override modal shows the project's imported budget values:

  • Project Fee — override fee value for the project. (Only for teams with Budget Tracking configured in Currency.)
  • Project Budget — override budget value of the bill rate for the project. (Only for teams with Budget Tracking configured in Currency.)
  • Project Budget Cost — override budget value of the cost rate for the project. (Only for teams with Budget Tracking configured in Currency and cost rate enabled.)
  • Project Budget Hours — override budget hours value for the project. (Only for teams with Budget Tracking configured in Hours rather than Currency.)

Clicking a budget cell opens this modal. Which budget number appears depends on the view you're in:

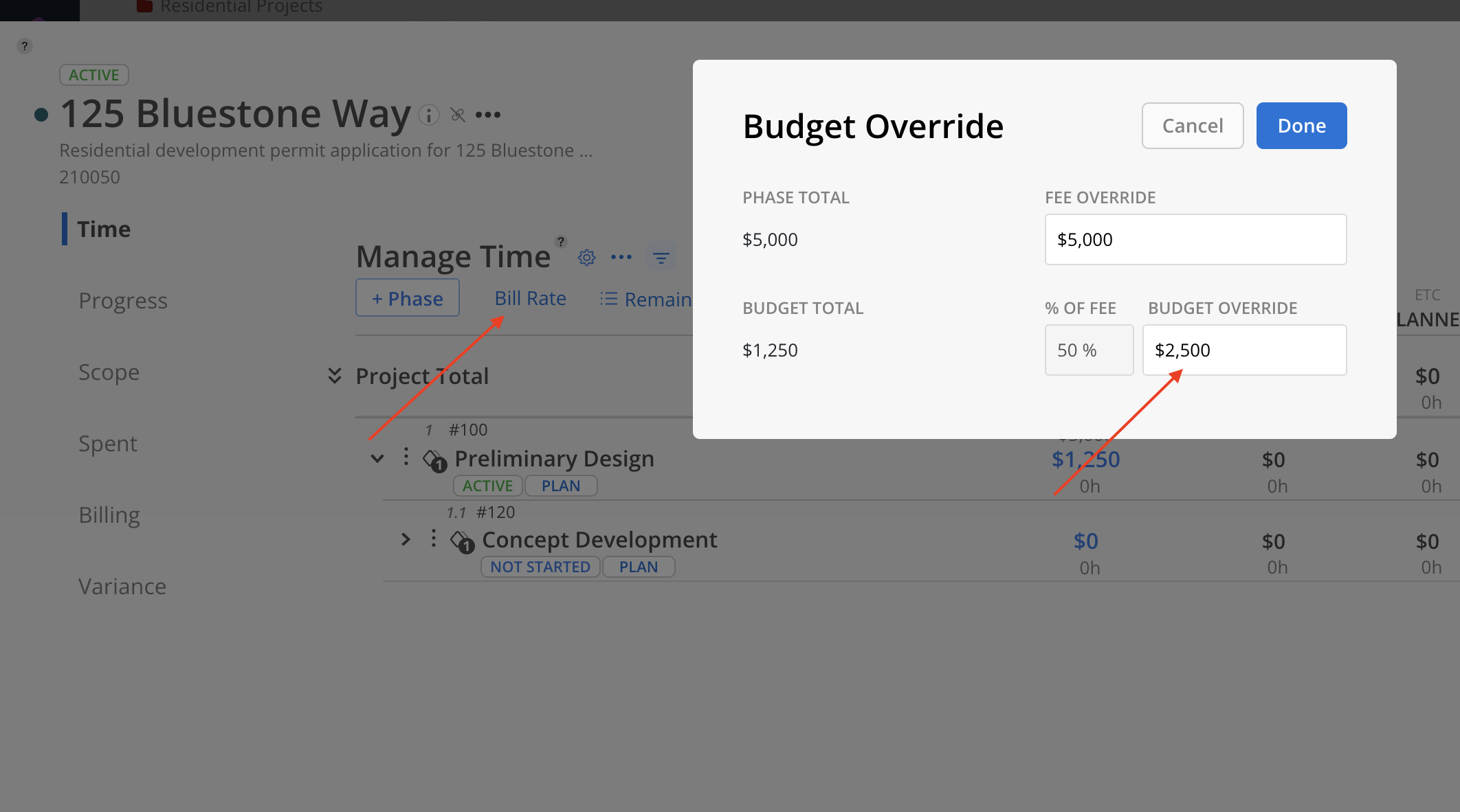

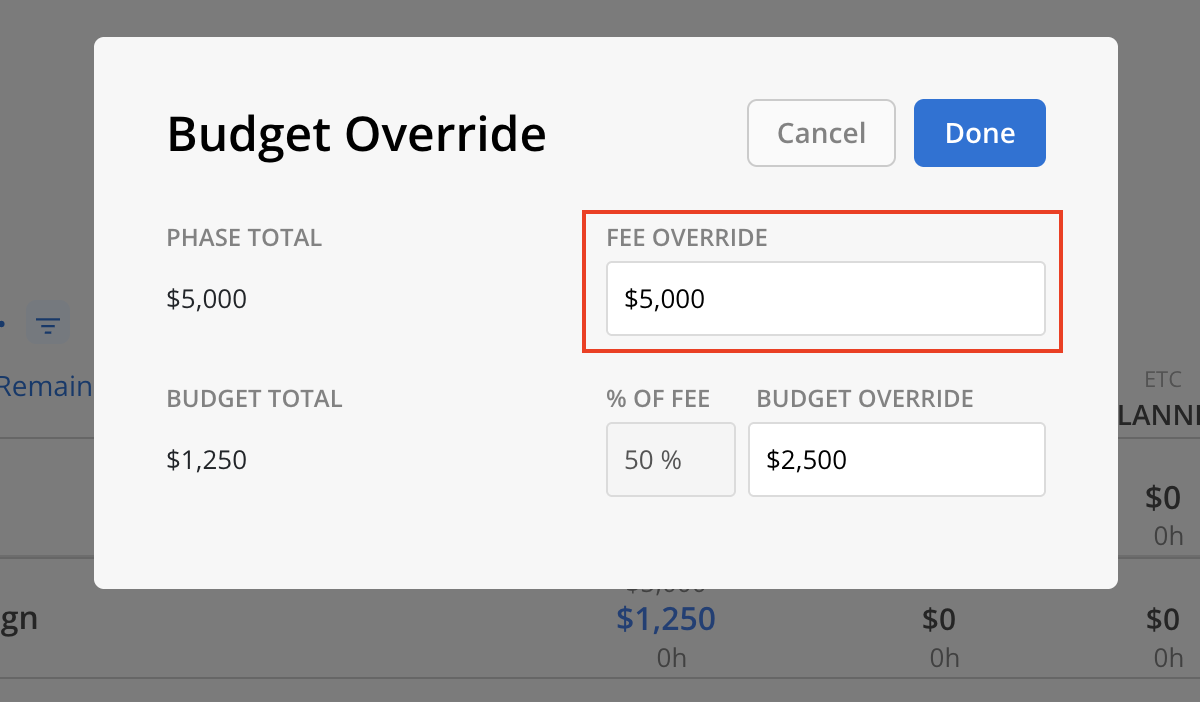

  • In bill rate view, the modal shows the Project Budget 125 Bluestone Way's 2,500.

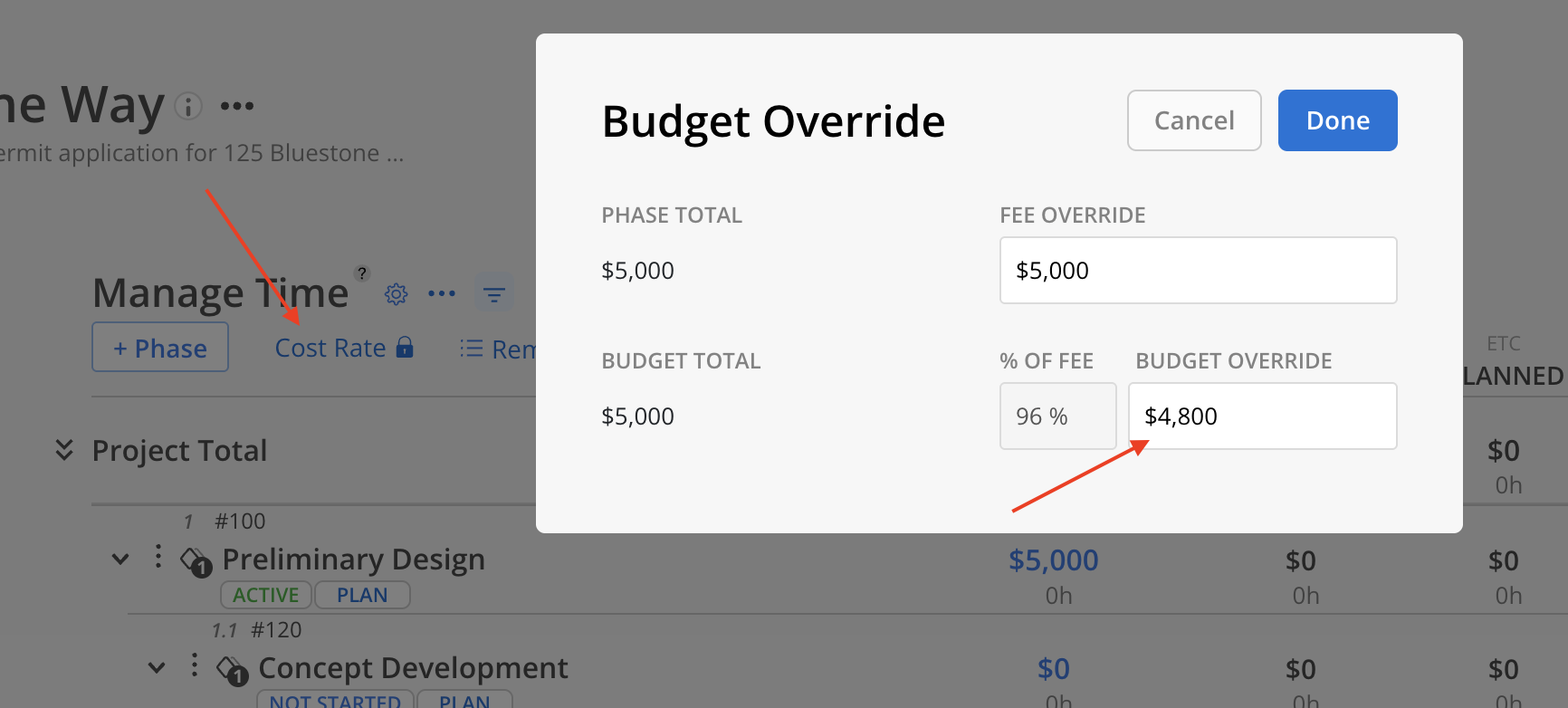

  • In cost rate view, it shows the Project Budget Cost — e.g. 48,000.

  • The Project Fee always shows in both views — e.g. 5,000.

The two hours-based projects (Riverside Community Center, Harbor Point Renovation) show their budgets in hours rather than fees, using the Project Budget Hours you set.

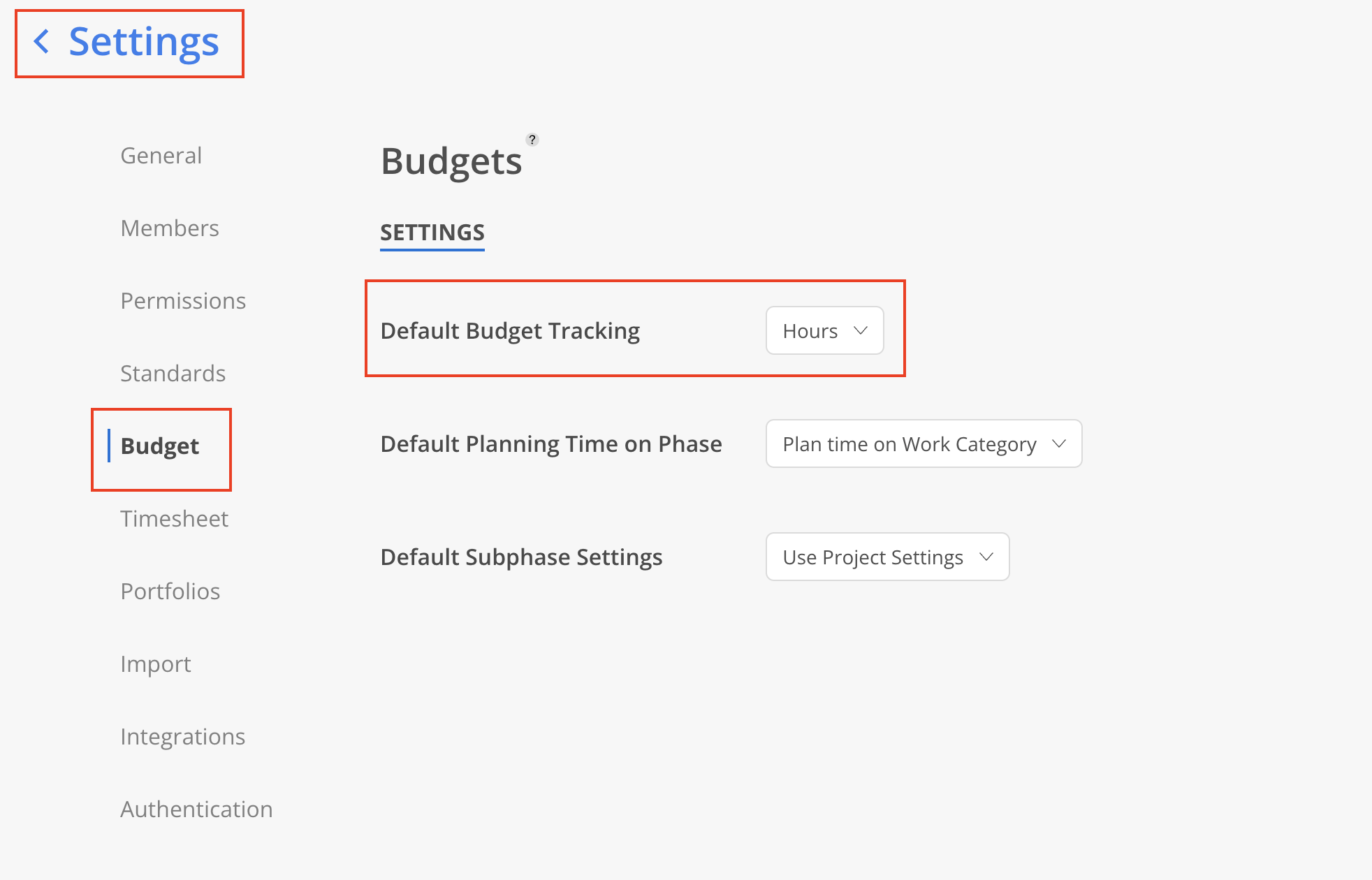

When your workspace is set to track budgets in hours (in your organization's budget settings), the Budget modal shows each project's total in hours instead of a currency amount.

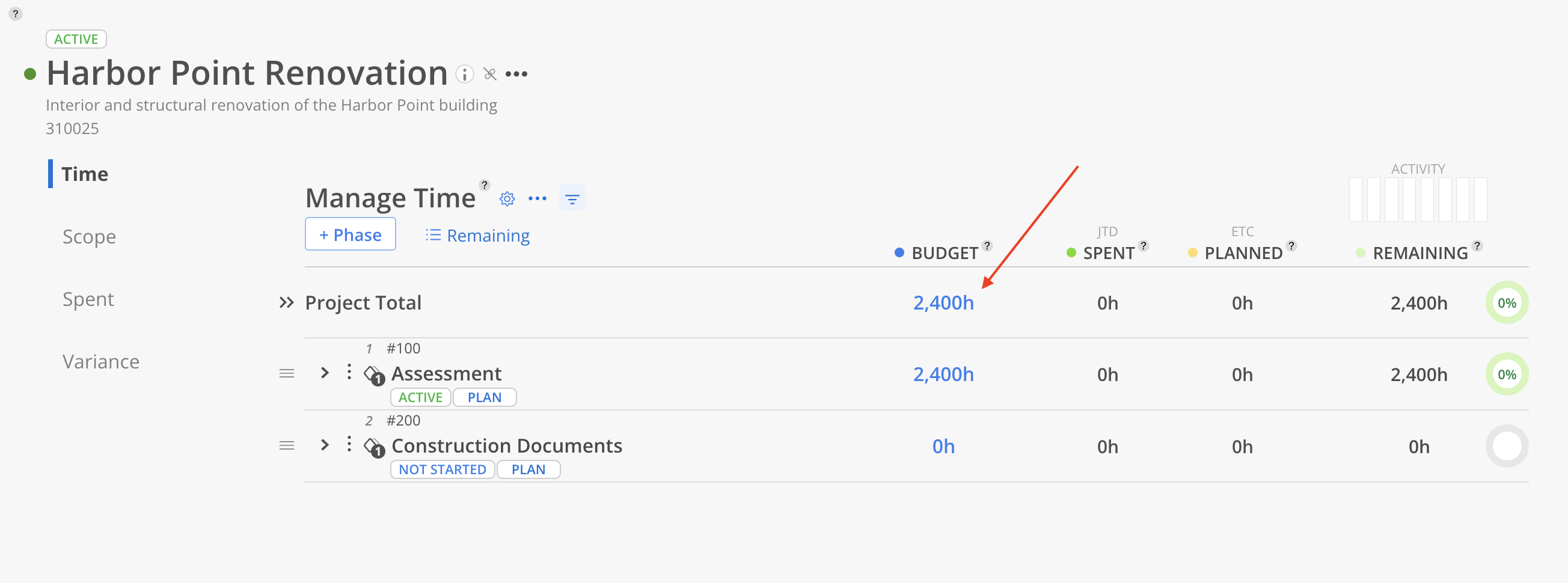

Click the budget cell on the project total row to open the override — for Harbor Point Renovation it shows the imported 2400.

Because the budget setting is hours rather than a currency, the override has no currency value attached.
